Planning Guide · 2026

How Long a Kitchen or Bathroom Remodel Takes, Phase by Phase

What happens in each phase, what each one waits on, the cure times and lead times that set the calendar, and the usual reasons a job runs long.

The question we hear right after "what will it cost" is "how long will we be torn up." The honest answer is that labor is only part of it. Cabinet lead times, inspections, membrane and mortar cure times, and countertop fabrication set the calendar as much as the crew does. Here's how a kitchen and a bathroom actually unfold, one phase at a time.

The short answer

  • Bathrooms. Fixr (updated January 2026) says most bathroom remodels take 2 to 12 weeks, with an average of 2 to 4 weeks from start to finish. Most of our bathroom remodels take two to four weeks from demo to final walkthrough, with a full gut and a custom tiled shower at the longer end.
  • Kitchens. HomeAdvisor (updated June 2026) puts the construction phase of a kitchen remodel at six to 10 weeks, and about four months once roughly four weeks of planning are added. Once cabinets arrive, most of our kitchens take four to eight weeks from demo to final walkthrough.
  • Smaller jobs. This Old House puts a professional tub-to-shower conversion at three to seven days. Details are in our tub-to-shower conversion guide.

Those ranges are wide because they measure different jobs. A same-layout bathroom with a prefab shower and a full gut with moved plumbing, a tiled pan and frameless glass are both "a bathroom remodel." Your schedule should come with your estimate, built from your scope and your selections.

Before demo: ordering, selections and permits

The best way to shorten the torn-up stretch is to do the waiting before anything gets torn out.

Cabinet lead times

This Old House (updated June 2026) says stock cabinets from home centers and popular retailers usually arrive within one to five weeks, semi-custom cabinets within five to six weeks, and custom cabinets in eight weeks to six months. For the semi-custom lines we install, we typically see three to eight weeks. Either way, cabinets get ordered and confirmed before the old kitchen comes out, and that's why our kitchen timelines are counted from when cabinets arrive.

Everything else with a lead time

Special-order vanities, tile, shower valves and trim kits, appliances and light fixtures can each hold up a job. We'd rather have them in your garage before demo than wait on a backorder with the plumbing open.

Permits

Like-for-like replacement usually doesn't need a permit. Moving plumbing, adding circuits, or changing framing usually does. In Philadelphia, L&I says an EZ permit typically takes about 5 business days, and standard plan review for residential alterations is listed at 15 business days. Montgomery County townships each set their own review times. Our permit guide has the details. When a permit is required, we pull it and schedule the inspections.

Bathroom remodel, phase by phase

A full bathroom with a tiled shower, in the order the work happens:

Bathroom remodel phases, what happens in each, and what each phase waits on
PhaseWhat happensWhat it waits on
1. DemoProtect floors and the path out, remove fixtures, tile and backing, haul away debrisWhat's found once the walls and floor are open
2. Repairs and framingReplace soft subfloor, straighten studs, add blocking for glass and grab bars, frame niches and curbExtent of hidden damage
3. Rough-inNew drain, supply and valve locations; new circuits, fan and lighting boxesLicensed trade partners' schedules
4. Rough inspectionInspector checks and approves the plumbing and electrical before walls closeTownship or L&I scheduling; only on permitted work
5. Backer and panCement or foam backer board on walls, shower floor built and slopedA mortar bed needs time to cure before waterproofing
6. Waterproofing and flood testMembrane over walls, pan, niche, curb and penetrations; pan filled with water to check for leaksMembrane dry or cure time, then the test period
7. TileFloor, shower walls, niche, curb, wainscotThinset cure before grouting
8. Grout and sealantGrout joints, flexible sealant at corners and changes of planeGrout cure before the shower is used
9. FinishVanity and top, toilet, valve trim, mirror, lights, paint, trimVanity top fabrication if it's stone
10. GlassMeasure after tile, then fabricate and installThe glass shop's turnaround
11. FinalFinal inspection where a permit was pulled, then walkthrough with youInspection scheduling

Two of these deserve a closer look. The rough inspection is a hard stop: the 2021 IRC that Pennsylvania's Uniform Construction Code adopts says plumbing can't be covered or put into use until it has been tested, inspected and approved. And steps 5 through 8 are a chain of cure times, covered below. If it's your only bathroom, we'll plan around keeping a working toilet.

Kitchen remodel, phase by phase

  1. Order and confirm cabinets. The lead time above, before demo.
  2. Set up a temporary kitchen. Fixr suggests budgeting for a temporary kitchenette or prepared meals when a remodel runs for weeks. A microwave, a coffee maker and the old refrigerator in the dining room go a long way.
  3. Demo. Cabinets, counters, flooring as needed, and any walls coming out. A wall that carries load needs an engineered beam, temporary support and a permit; our load-bearing wall guide covers that process.
  4. Rough-in and inspection. New circuits for appliances and lighting, plumbing moved for a relocated sink or a pot filler, venting for the hood. Pennsylvania's UCC calls for inspections of plumbing, mechanical and electrical systems, framing, and wallboard on permitted work, and Lower Providence Township, where we're based, requires a third-party electrical inspection before the rough framing inspection.
  5. Drywall, patching and paint primer. Easier to do with the cabinets out of the way.
  6. Flooring. Depending on the material, floors go in before or around the cabinets. See our LVP vs. hardwood guide for how each floor handles a kitchen.
  7. Cabinets. Set, leveled and fastened. Base cabinets have to be dead level before the counters can be measured.
  8. Countertop template. The fabricator measures the installed cabinets. Templating usually happens about a week after cabinets are set.
  9. Countertop fabrication and install. Caesarstone says a very customized quartz job can take 7 to 10 days to fabricate, and simpler ones as little as 1 to 2 days, on top of the shop's schedule. Caesarstone also notes you can use quartz counters right after they're installed.
  10. Backsplash, sink and hookups. Backsplash tile goes on after the counters. The sink, faucet, disposal and dishwasher get connected. You'll be without a sink for part of the project, and we'll tell you which days when we set the schedule.
  11. Trim, paint, punch list and final. Crown, toe kick, light fixtures, hardware, touch-up, final inspection where a permit was pulled, and a walkthrough of every drawer and door.

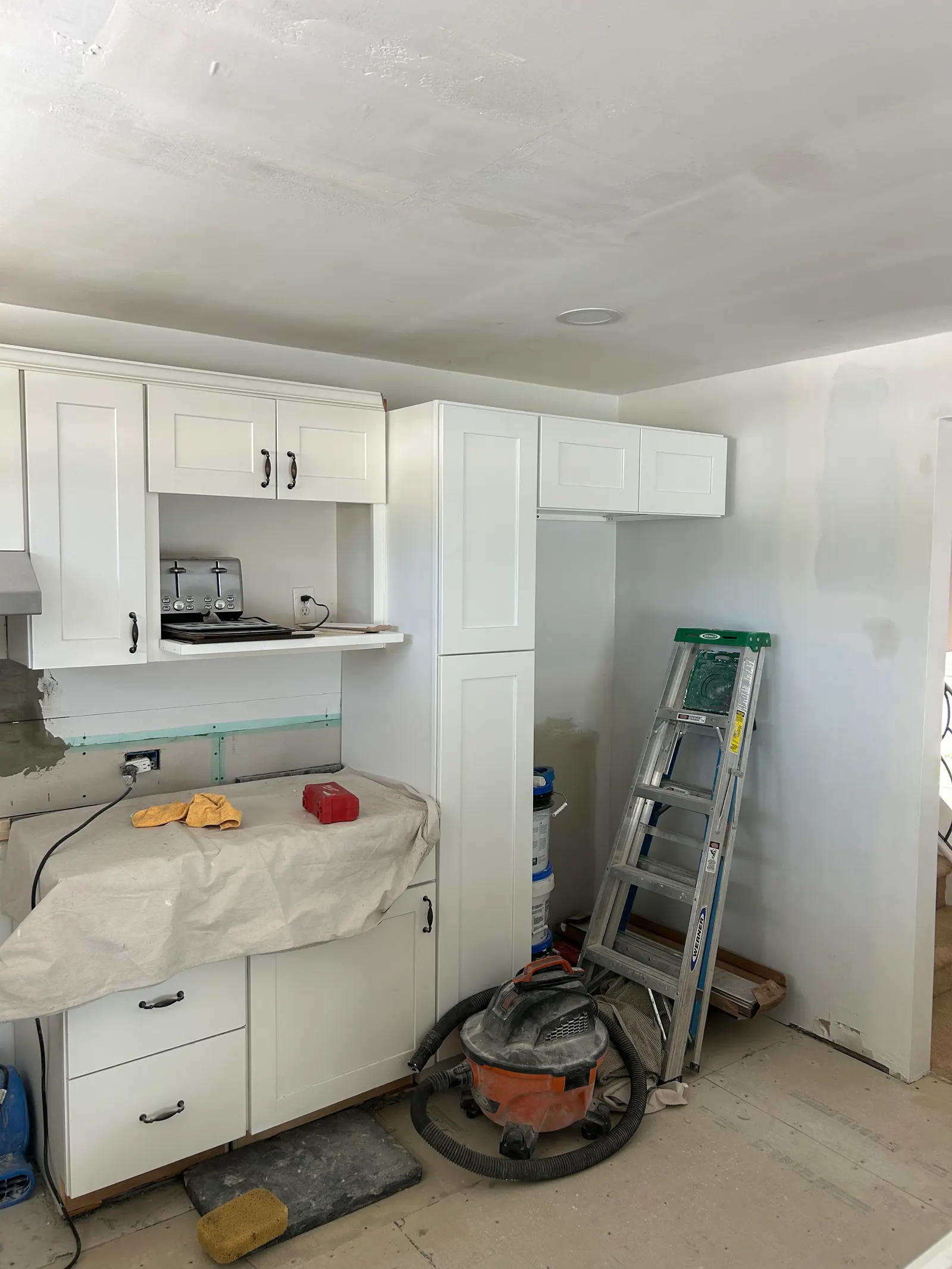

Kitchen remodel with white shaker cabinets, skylight, and rustic wood-look plank flooring underway
Cabinets set and leveled on three walls, ready for the countertop template. From our white shaker pantry kitchen.

Cure times and lead times that set the calendar

Waiting days on a remodel aren't idle days. They're usually a product cure time or a supplier's lead time. Published examples:

Published cure times and lead times for common remodel steps
StepPublished timeSource
Liquid membrane, RedGard type
Two coats; dries pink to red
1 to 1.5 hours per coat; up to 12 hours in cold or humid conditions; flood test once both coats are dryCustom Building Products TDS-104
Liquid membrane, Hydro Ban type
Changes from light sage to olive green
Flood test in 2 hours at 70°F or higherLATICRETE
Sheet membrane, Kerdi type
Set in thinset
Tile can go on right away; wait at least 24 hours before a water test, which typically runs 24 hoursSchluter Systems
Mortar shower bedSeveral days to cure the base and top layersHomeGuide
Thinset under tile18 to 24 hours before groutingCustom Building Products Multi-Bond data sheet
CabinetsStock 1 to 5 weeks; semi-custom 5 to 6 weeks; custom 8 weeks to 6 monthsThis Old House (2026)
Quartz countertop fabrication1 to 2 days simple; 7 to 10 days very customizedCaesarstone

Every product has its own data sheet, and temperature matters. Custom Building Products says RedGard needs surfaces above 40°F during application and for 72 hours after, and Schluter recommends waiting longer than 24 hours before a water test when the room is around 50 to 60°F. A bathroom over an unheated crawlspace in January cures slower than the same bathroom in June. How the waterproofing steps fit together is in our shower waterproofing guide.

What causes remodel delays

Fixr lists room size, the changes being made, surprise mold or water damage, and material arrival as what drives a bathroom's timeline. In our experience the list looks like this:

  1. What's behind the walls. Many homes here were built between the 1920s and 1970s. Soft subfloor, old cast-iron or galvanized drains, ungrounded wiring and tile set in mortar show up once the room is opened. This Old House reports tub-to-shower conversions run into hidden costs nearly 70 percent of the time. We stop, show you, and price the fix in writing before doing it, and the decision is yours before work continues.
  2. Selections made late. Tile picked after demo, a vanity that turns out to be special order, or a faucet that doesn't fit the valve.
  3. Deliveries. A damaged cabinet box or a backordered part can stall the trades waiting behind it.
  4. Inspections. Scheduling depends on the township or L&I, and a failed inspection means a fix and a re-inspection before the walls can close.
  5. Change orders. Moving the vanity a foot after rough-in is done means redoing rough-in.
  6. Countertop re-templates. If a cabinet gets moved or a sink is swapped after templating, the fabricator measures again.
  7. Glass. It can't be measured until tile is done, so a slow glass shop adds days at the very end.

How to keep your remodel on schedule

  • Make every selection, down to grout color and cabinet hardware, before demo.
  • Have special-order items delivered and checked before the room is torn out.
  • Decide ahead of time how you want to handle a surprise, so a rotted subfloor is a quick yes or no instead of a week of back and forth.
  • Plan around the hard stops: rough inspection, flood test, countertop template, glass measure.
  • Ask for a written schedule with the estimate, including the days you'll be without a sink or a toilet.

Every project starts with a free walkthrough and a written, itemized estimate, and we give you a schedule with it, including which days you'll be without a sink. New rough-in is done with licensed trade partners we coordinate, and when a permit is needed we pull it and schedule the inspections. Request your estimate.

Projects in progress

These are our own job sites, photographed mid-project. See the kitchen remodeling and bathroom remodeling pages for how we run each kind of job, or the white kitchen with quartz and subway tile write-up for a kitchen from cabinets to backsplash.

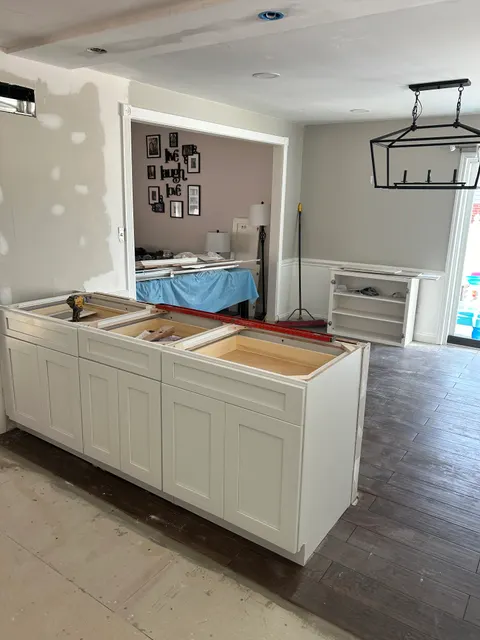

Kitchen remodel in progress with new white shaker pantry cabinets and wood-look tile floor Kitchen remodel nearing completion with white cabinets, quartz counters, and stainless appliances Shower renovation in progress with red waterproofing membrane and dark large-format tile White subway tile tub surround installation over waterproofing membrane

Remodel timeline questions

How long does a bathroom remodel take?

Fixr puts most bathroom remodels at 2 to 12 weeks, averaging 2 to 4 weeks. Most of our bathroom remodels take two to four weeks from demo to final walkthrough, with a full gut and a custom tiled shower at the longer end.

How long does a kitchen remodel take?

HomeAdvisor puts the construction phase at six to 10 weeks, and about four months including planning. Once cabinets arrive, most of our kitchens take four to eight weeks from demo to final walkthrough. Cabinet lead time is the biggest variable.

Why does it take so long to get countertops?

Countertops can't be measured until the cabinets are installed and level. Templating usually happens about a week after cabinets are set, and Caesarstone says fabrication can take 1 to 2 days for a simple quartz job and 7 to 10 days for a very customized one, plus the shop's schedule.

Why is there waiting time in the middle of a shower build?

The pan, membrane, thinset and grout each need to dry or cure before the next step. For example, Schluter recommends waiting at least 24 hours before water testing its membrane, and Custom Building Products calls for 18 to 24 hours of thinset cure before grouting.

Can I live in the house during a remodel?

Usually, yes. Plan on a temporary kitchen setup for a kitchen remodel and a few days without a sink. If you only have one bathroom, ask your contractor how they'll keep a working toilet available.

Sources
